基于动态贝叶斯网络的TBM卡机风险预测
Risk prediction of TBM jamming based on dynamic Bayesian network
通讯作者:
收稿日期: 2020-05-20
基金资助: |
|
Received: 2020-05-20
Fund supported: | 国家自然科学基金资助项目(51668037) |
作者简介 About authors
颉芳弟(1994—),女,硕士生,从事隧道风险管理研究.orcid.org/0000-0002-1506-9700.E-mail:
为了预测隧道机械施工时隧道掘进机(TBM)卡机风险,基于动态贝叶斯网络(BN)分析卡机概率系统. 通过专家知识以及解释结构模型确定风险因素和风险事件的因果关系,收集国内隧道机械施工地质条件实测数据,根据相关规范、研究成果和云模型云间划分法对风险指标进行区间划分,运用粗糙集分类原理对数据进行离散化,获取风险因素的原始先验概率和风险事件的条件概率. 结合软件GENIE,建立动态BN模型预测卡机风险. 结果表明:在无证据条件下,TBM卡机风险概率为8%;造成TBM卡机的关键风险因素是岩石类型、大量的地下水和断裂破碎带. TBM卡机的关键致因链为岩石类型→掌子面突泥涌沙→卡刀盘→卡机,大量的地下水→掌子面突泥涌沙→卡刀盘→卡机,高地应力→软岩大变形→卡护盾→卡机,围岩坍塌→卡护盾→卡机.
关键词:
A probability system of jamming was analyzed based on dynamic Bayesian network(BN), in order to predict the risk of tunnel boring machine (TBM) jamming during tunnel mechanical construction. Through expert knowledge and explanation structure model to determine the causal relationship between risk factors and risk events, collecting the measured data of domestic tunnel mechanical engineering geological conditions. The risk indicators were divided according to the relevant specifications, the research results and the cloud division method of cloud model into internal division. The rough set classification principle was applied to discretization of data to obtain the original prior probability of risk factors and the conditional probability of risk events. Combined GENIE software a dynamic BN model was established to predict the risk of card machines. Results show that the risk probability of TBM jamming is 8% under the condition of no evidence. The key risk factors of TBM jamming are rock type, large amount of groundwater and fracture zone. The key cause chain of TBM clamping machine is as follows: rock type → progradation of mud and sand on palm face → clamping knife plate → clamping machine, a large amount of groundwater → progradation of mud and sand on the palm surface → clamping knife plate → clamping machine, high ground stress → large deformation of soft rock → clamping shield → clamping machine, surrounding rock collapse → clamping shield → clamping machine.
Keywords:
本文引用格式
颉芳弟, 翟强, 顾伟红.
XIE Fang-di, ZHAI Qiang, GU Wei-hong.
近些年,因隧道掘进机(tunnel boring machine,TBM)施工工法在技术上可行,对环境的危害较小,被广泛应用于大型隧道施工中. 然而,TBM在不良地质掘进过程中,选型一旦确定就不便更改. 地质因素对TBM选型的影响更为复杂,从刀盘形式、推力、扭矩、支护系统及其他后配套系统均有较大的影响[1]. 如果在隧道掘进过程中遇到围岩坍塌、大量地下水突涌、涌沙等风险事件,将会造成巨大的经济损失和工期延误. 因此,建立TBM卡机模型防范主要风险,有利于施工企业对风险的控制以及安全管理工作.
Sousa[2]在2010年建立隧道施工可能出现的风险事故数据库.Abdelgawad等[3]结合地铁施工安全提出先验概率风险评估(probabilistic risk assessment, PRA)模型,描述风险事故的出现以及相关风险因素的概率分布,目的是识别关键风险因素和潜在风险事件,帮助项目工程师在施工阶段及时发出预警并采取弥补措施. 2012年,Sousa等[4]提出基于贝叶斯网络(Bayesian network,BN)的地质预测模型,结合TBM的掘进性能数据和BN模型很好地预测了掌子面前方的地质情况. 最传统的方法是故障树分析法(fault tree analysis, FTA)——一种能有效预测风险事件出现频率的概率评估方法[5-6]. 在2004年出版的《隧道风险管理指南》一文中,国际隧道协会(International Tunneling Association,ITA)将FTA高度推荐应用在隧道风险分析与评估中. 2015年,Hyun等[7]利用FTA和层次分析法识别TBM在不良地质情况下最有可能出现的风险事件,并在实际工程中得到较好的应用. 在国内,2013年,周宗青等[8]利用风险评估模型和风险规避方法规避了一次地质灾害. 2015年,佘诗刚等[9]列举TBM在隧道施工中的卡机案例并分析卡机原因和造成的后果,并指出研究TBM地质适应性将是未来的重大课题. 2017年,陈发达等[10]应用BN对盾构隧道施工中刀盘失效进行风险评估. 2018年,顾伟红等[11]采用基于熵权法的模糊综合评估模型分析西秦岭特长铁路隧道TBM施工风险,识别关键风险因素. 2019年,吕擎峰等[12]采用模糊层次和后果当量法评估隧道的塌方风险;同年,黄震等[13]基于模糊−证据理论综合评价盾构施工过程中的风险,解决了盾构隧道风险评价的不确定性,提高了评价结果的置信度. 同时,超前地质预测技术和风险评估方法的结合将会成为隧道风险评估研究的主流方向,但现在技术还不成熟[14].
以上方法依赖于输入风险数据的真实性与有效性,而在实际工程中风险的高度不确定性意味着获得可靠数据的机会很少. 粗糙集能客观地处理随机与冗余不确定性问题,有效地弥补这一缺陷,却不能直观地表达概率变化和反向推理;恰好BN是随机图论和具有反诊断与反推理的模型. 虽然粗糙集和BN方法的互补融合已在医疗决策、电子产品、机械故障处理[15-17]等领域取得良好的效果,但很少应用于隧道施工风险研究领域,同时关于TBM卡机风险分析的研究在国内较少,本文结合粗糙理论和BN建立TBM卡机风险模型,以北疆供水二期工程双三段引水隧洞项目为例验证模型的可靠性. 为TBM施工卡机这一风险不确定性的非线性问题提供有效可行的新解决途径.
1. 研究方法
1.1. BN
BN是基于贝叶斯理论的不确定性知识的概率图推理模型,是目前不确定性知识表达和推理领域最有效的工具之一[18]. BN是一种因果关系的网络图,它能利用在不确定和复杂条件下已获得的知识推论出逻辑结果. BN天生具有分析不确定性信息的能力,可以将数据不完备的系统进行推理和反推理,反映系统中数据间的概率关系. BN分析对数据结果的可能性,进一步量化并将先验结果与数据知识相结合,表示系统中各因素间依赖关系的强弱. BN也可以根据后期提供的数据更新系统中各因素的概率值,推翻之前的结论进一步提高预测精度. BN模型中所有节点都可见,增强了推理的精确性. 这种从不完全、不确定或不精确的系统中得出准确推理的模型,特别适合用于像TBM施工这种高度非线性多控制因素的复杂系统.
BN图是由几种代表变量的节点组成的有向循环图,并且用有向箭头将节点连接起来表示因果关系. 如图1所示,在BN中,每个变量是有限定和相互独立的,每个节点由一组概率(通常用n×m表格表示)代表当前节点的条件概率. 图中,A节点叫作C节点的父节点(也称为根节点或风险因素),即在A与C的关系中,C是子节点(也称为中间节点或风险事件);除了A和B没有父节点,其他所有的节点由于与父节点连接而具有条件概率. 图中节点的概率分别表示为p(a)、p(b)、p(c|a,b)、p(d|c)、p(e|c)、p(f |e)和p(g|d,e,f).
图 1
BN评价步骤可分为4步:1)将识别好的风险因素和风险事件根据因果关系转化为BN拓扑图;2)根据专家先验知识或者统计数据获取根事件的先验概率;3)根据专家先验知识或统计数据获取中间事件的条件概率;4)BN模型的概率计算,通常可以借助Matlab、Netic、Genie等软件进行模拟计算.
1.2. 粗糙理论
粗糙集(rough sets)理论是波兰数学家帕拉克提出的关于系统逻辑特性研究的高效解析不精确、不完整信息的数学方法[19]. 其主要理论如下:粗糙集理论用信息系统
1.3. 连续型影响因素离散化
粗糙集对不确定性问题的描述及处理是比较客观的,其属性值都是离散数据,为了方便计算使数据统一化,需要将连续数据与离散数据做综合处理,使连续数据转化成离散数据. 常用的离散化方法有替换法、离散相似法、遗传算法以及等区间离散化法等,这类方法实质上将连续的区间划分为小的区间,并将连续的小区间与离散的值关联起来,过程复杂难懂,不适用于大量数据的处理. 云变换可以实现对连续数据的软划分,既能根据某种规律将任意不规则的空间数据分布进行数学变换,又适用于大量数据的处理,因此本文运用云模型划分区间,通过区间离散实现连续属性的离散化.
云模型是李德毅创立的定性与定量相互转换的不确定性模型,用
基本云模型的合并需要考虑决策表的改变程度,
式中:
2. 基于贝叶斯的TBM卡机可能性评价流程
基于贝叶斯理论原理,借助历史资料、专家主观经验和客观数据,构建BN模型求得其概率,结合实际项目进行实例论证. 如图2所示为使用BN模型对TBM卡机风险预测的模型构建路线流程.
图 2
2.1. TBM卡机风险因素
表 1 TBM施工卡机风险指标
Tab.1
风险指标 | 符号 | 风险指标 | 符号 | |
岩石类型 | A1 | 刀盘结构的设计 | B3 | |
大量的地下水 | A2 | TBM操作 | C1 | |
高地应力 | A3 | 前期地质调查 | C2 | |
复合地层 | A4 | 卡刀盘 | M1 | |
断裂破碎带 | A5 | 卡护盾 | M2 | |
围岩等级 | A6 | 姿态偏差 | M3 | |
隧道埋深 | A7 | 围岩坍塌 | M4 | |
平曲线半径 | A8 | 岩爆 | M5 | |
TBM选型 | B1 | 突泥涌沙 | M6 | |
开口率的设计 | B2 | 软岩大变形 | M7 |
2.2. 风险指标等级划分
风险指标等级的划分规则:1)根据规范进行划分,2)根据研究文献成果划分,3)根据云模型进行区间软划分. 实际上划分区间越多,越细致,分析结果越准确,但区间越多,会大大增加BN模型的计算量. 用1~5表示具体指标的相关状态,这些状态不表现风险高低. 例如指标姿态偏差M3状态1表示偏差最小,则TBM在该状态下,最适宜掘进,掘进效率最好;指标突泥涌沙M6状态1表示涌水量最大,则TBM在该状态下,掘进效率最差,极可能发生掌子面涌水,迫使停机现象.
图 3

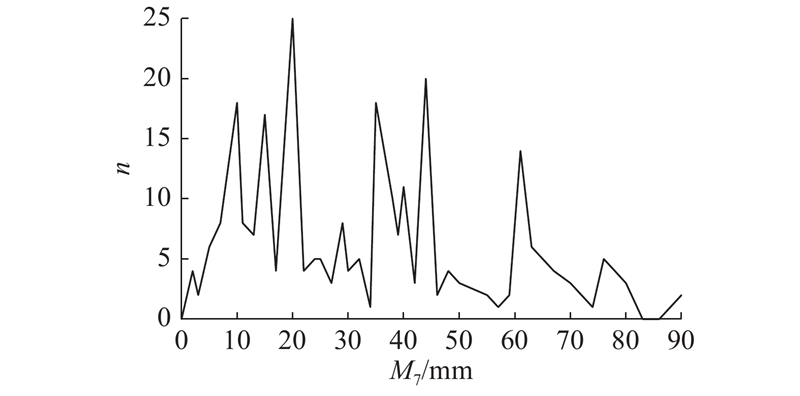

图 3 软岩大变形统计数据的原始分布
Fig.3 Original distribution of statistical data for soft rock large deformation
表 2 软岩大变形的初始云模型数字特征及相邻云间距离
Tab.2
云编号 | Ex | En | He | d |
1 | 10 | 3.241 5 | 0.402 4 | 0.764 65 |
2 | 15 | 3.297 4 | 0.411 4 | 0.752 67 |
3 | 20 | 3.345 6 | 0.422 8 | 1.154 85 |
4 | 28 | 3.581 7 | 0.432 1 | 0.971 80 |
5 | 35 | 3.624 4 | 0.442 2 | 0.672 89 |
6 | 40 | 3.697 4 | 0.452 3 | 0.674 84 |
7 | 45 | 3.711 8 | 0.462 1 | 2.675 84 |
8 | 65 | 3.762 5 | 0.468 9 |
云5和云6间距离最短,为0.672 89,若属性值相对于决策分类的不确定差值小于阈值(
图 4
图 4 软岩大变形的云模型划分最终结果
Fig.4 Final results of cloud model division for soft rock large deformation
表 3 TBM卡机风险定量评价指标分级标准
Tab.3
符号 | 风险指标 | 分级依据 | 分级状态 | ||||
1 | 2 | 3 | 4 | 5 | |||
M3 | 姿态偏差 | 偏移量/mm | | | | | |
M6 | 突泥涌沙 | 掌子面涌水量/(m3·h−1) | | | | | |
M7 | 软岩大变形 | 围岩收敛值/mm | | | | | |
A2 | 大量的地下水 | 单位涌水量/(L·s−1) | | | | | |
A3 | 高地应力 | 围岩强度应力比 | | | | | |
A4 | 复合地层 | 横向地层复合比/% | | | | | |
A5 | 断裂破碎带 | 破碎带宽度/m | | | | | |
A6 | 围岩等级 | 纵波波速/(km·s−1) | | | | | |
A7 | 隧道埋深 | 埋深/m | | | | ||
A8 | 平曲线半径 | 半径/mm | | | | | |
B2 | 开口率的设计 | 开口率/% | | | | ||
C2 | 前期地质调查 | 勘测结果准确率/% | | | | | |
表 4 TBM卡机风险定性评价指标分级标准
Tab.4
符号 | 风险指标 | 分级依据 | 分级状态 | |||
1 | 2 | 3 | 4 | |||
G | 卡机 | 是否卡机 | 是 | 否 | ||
M1 | 卡刀盘 | 是否卡刀盘 | 是 | 否 | ||
M2 | 卡护盾 | 是否卡护盾 | 是 | 否 | ||
M4 | 围岩坍塌 | 围岩形态 | 稳定 | 部分坍塌 | 严重坍塌 | |
M5 | 岩爆 | 岩爆烈级 | 无岩爆 | 弱岩爆 | 中等岩爆 | 强烈岩爆 |
A1 | 岩石类型 | 风险描述 | 强可溶岩 | 中等可溶岩 | 弱可溶岩 | 非可溶岩 |
B1 | TBM选型 | 风险描述 | 不宜选择TBM施工 | TBM型号选择不当 | TBM型号选择适当 | |
B3 | 刀盘设计 | 风险描述 | 刀盘直径不合理 | 刀具设计不合理 | 刀盘结构形式不合理 | 刀盘设计合理 |
C1 | TBM操作 | 风险描述 | 地质条件复杂, 推进速度控制困难 | 地质条件良好, 操作人员操作失误 | 合理换步,并选择合理 的施工参数 |
2.3. BN拓扑图的构建
图 5

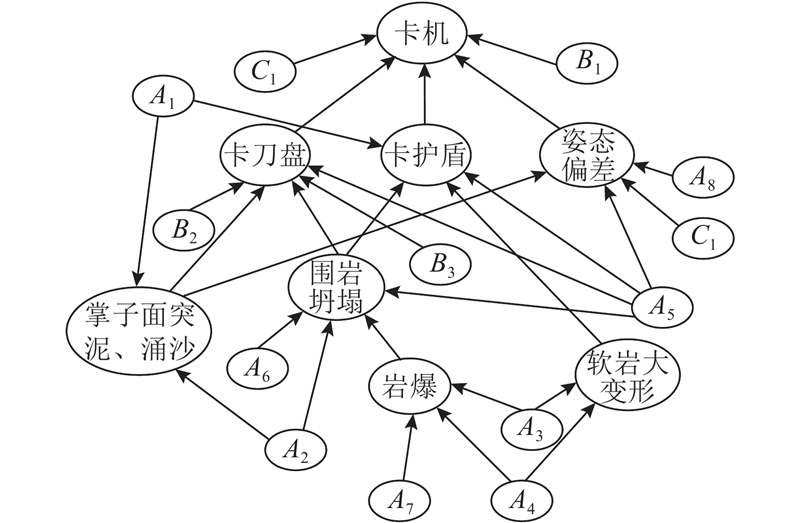

图 5 TBM卡机风险因素和风险事件的相关性
Fig.5 Correlation of risk factors and risk events for TBM jamming
图 6
2.4. 先验概率和条件概率的获取
2.4.1. BN模型参数化
表 5 TBM卡机决策表(部分)
Tab.5
区间组别 | A1 | A2 | A3 | A4 | A5 | A6 | A7 | A8 | B1 | B2 | B3 | C1 | C2 | M1 | M2 | M3 | M4 | M5 | M6 | M7 | G |
1 | 3 | 3 | 3 | 4 | 5 | 3 | 2 | 3 | 3 | 2 | 4 | 3 | 2 | 2 | 2 | 1 | 2 | 2 | 3 | 3 | 2 |
2 | 4 | 4 | 5 | 3 | 5 | 2 | 3 | 3 | 3 | 2 | 4 | 3 | 4 | 2 | 2 | 1 | 2 | 3 | 4 | 2 | 2 |
3 | 2 | 2 | 4 | 4 | 4 | 2 | 2 | 3 | 3 | 2 | 2 | 1 | 5 | 2 | 1 | 2 | 2 | 3 | 4 | 2 | 1 |
4 | 4 | 3 | 3 | 2 | 4 | 3 | 2 | 4 | 3 | 2 | 2 | 2 | 2 | 2 | 2 | 1 | 1 | 1 | 4 | 3 | 2 |
5 | 3 | 2 | 3 | 1 | 3 | 3 | 2 | 4 | 3 | 2 | 4 | 3 | 3 | 2 | 2 | 1 | 1 | 1 | 3 | 3 | 2 |
| | | | | | | | | | | | | | | | | | | | | |
400 | 3 | 4 | 3 | 1 | 5 | 4 | 3 | 3 | 3 | 3 | 2 | 3 | 2 | 1 | 2 | 2 | 1 | 2 | 2 | 4 | 1 |
2.4.2. 计算先验概率和条件概率
利用粗糙集分类原理,根据表5计算根节点的先验概率和中间节点的条件概率:
式中:
表 6 风险因素的先验概率
Tab.6
符号 | 风险因素指标 | P | ||||
状态1 | 状态2 | 状态3 | 状态4 | 状态5 | ||
A1 | 岩石类型 | 0.114 | 0.354 | 0.287 | 0.245 | |
A2 | 大量地下水 | 0.050 | 0.125 | 0.543 | 0.282 | |
A3 | 高地应力 | 0.342 | 0.334 | 0.139 | 0.103 | 0.082 |
A4 | 复合地层 | 0.085 | 0.082 | 0.124 | 0.667 | 0.042 |
A5 | 断裂破碎带 | 0.085 | 0.124 | 0.221 | 0.221 | 0.349 |
A6 | 围岩等级 | 0.024 | 0.094 | 0.187 | 0.425 | 0.270 |
A7 | 隧道埋深 | 0.015 | 0.930 | 0.055 | ||
A8 | 平曲线半径 | 0 | 0.054 | 0.292 | 0.654 | |
B1 | TBM选型 | 0.045 | 0.024 | 0.931 | ||
B2 | 开口率的设计 | 0.124 | 0.721 | 0.155 | ||
B3 | 刀盘设计 | 0.097 | 0.134 | 0.024 | 0.745 | |
C1 | TBM操作 | 0.088 | 0.024 | 0.888 | ||
C2 | 前期地质调查 | 0.124 | 0.115 | 0.167 | 0.211 | 0.383 |
表 7 风险事件M3的条件概率(部分)
Tab.7
A5 | A8 | C1 | M6 | | |||
状态1 | 状态2 | 状态3 | 状态4 | ||||
1 | 1 | 1 | 1 | 0 | 0 | 0.138 | 0.872 |
1 | 1 | 1 | 2 | 0 | 0 | 0.336 | 0.674 |
1 | 1 | 1 | 3 | 0.104 | 0.221 | 0.223 | 0.452 |
1 | 1 | 1 | 4 | 0.110 | 0.142 | 0.325 | 0.423 |
1 | 1 | 2 | 2 | 0 | 0.271 | 0.274 | 0.455 |
| | | | | | | |
5 | 4 | 3 | 2 | 0 | 0.372 | 0.542 | 0.086 |
5 | 4 | 3 | 3 | 0.212 | 0.245 | 0.342 | 0.201 |
5 | 4 | 3 | 4 | 0.844 | 0.131 | 0.025 | 0 |
3. 案例分析
3.1. 工程概况
北疆供水二期工程隧洞穿越的地质条件复杂,具有埋深大,超特长的特点,是世界上已建和在建的最长引水隧洞. 主要是由喀双隧洞、西二隧洞、双三隧洞3部分组成,隧洞占总长度的95.6%以TBM施工为主,钻爆法施工为辅. 其中双三隧洞长92.15 km,采用2台直径为5.53 m的敞开式TBM和3台土压力平衡盾构施工. 主要穿越泥盆系和石炭系凝灰质砂岩、凝灰岩以及华力西晚期侵入的花岗岩地层总长65.34 km;侏罗系和白垩系的泥岩、砂岩地层长13.19 km;新近系的泥岩夹砂岩长11.23 km;第四系碎石土长1.91 km. 双三隧洞地质纵断面,如图7所示. 图中,S为桩号,H为高程. 隧洞Ⅱ、Ⅲ类围岩占总长的68.9%,饱和抗压强度介于30~120 MPa的岩石占比为67.0%,饱和抗压强度小于30 MPa的围岩占比为29.0%,主要为泥岩夹砂岩,在施工中可能存在局部坍塌、大规模突涌水、软岩大变形问题.

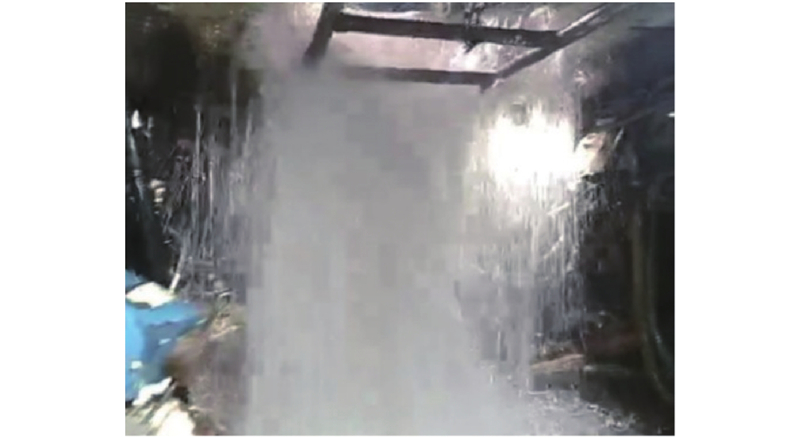

图 7
本文以双三隧道TBM1施工段(21+004.542~21+543.213)、TBM1施工段(40+022.111~41+025.123)、TBM2施工段(50+409.187~51+011.235)为研究对象,对模型的可靠性进行验证.
3.2. 事前风险推理分析
构建卡机BN拓扑图和获取根事件的先验概率和中间事件的条件概率后,即可进行BN模型的推理分析. 将已获得的参数数据输入GENIE 2.0软件,在对决策表中的实测数据进行统计分析得到无证据条件下的TBM卡机风险预测结果,如图8所示.
图 8

图 8 无证据条件下的TBM卡机贝叶斯网络模型
Fig.8 Bayesian network model of TBM jamming without evidence
3.3. 事中风险推理分析
在TBM2施工段,随着TBM施工推进,经过现场调查,掌握证据(A1=2、A2=1、A3=4、A4=3、A5=2、A6=2、A7=2、A8=3、B1=3、B2=2、B3=4、C1=1、C2=4)则可通过更新节点的概率,动态更新BN模型,更新后的BN模型,如图9所示. 由图可以看出,卡机风险概率为47%.
图 9
图 9 有证据条件下的TBM卡机贝叶斯网络模型(TBM2施工段)
Fig.9 Bayesian model of TBM jamming with evidence (section TBM2)
3.3.1. 软件敏感度分析和致因链分析
3.3.2. 软件后验概率计算
后验概率是在先验概率的基础上结合贝叶斯概率公式反推而来的,在本文中指在设定顶事件一定发生的情况下,反推底事件发生的概率分别是多少,并通过底事件的后验概率反应各个底事件的重要程度,以便找出致因因子. 将结果整理成柱状图比较先验概率和后验概率,如图10所示. 由图可看出A1、A2、A5先验概率和后验概率变化幅度较大,其他根节点只有略微变化,故这3个因素为关键因素.
图 10
图 10 无证据条件下先验概率(左)和后验概率(右)柱状图
Fig.10 Bar charts of prior probability (left) and posterior probability (right) without evidence
同理,可对TBM1施工段(21+004.542~21+543.213)、TBM1施工段(40+022.111~41+025.123)进行推理分析,获取TBM卡机概率PJ、敏感性因子F、致因链C ′、关键致因因素F ′,最终推理结果如表8所示.
此处的卡机概率并不是TBM卡机的故障率,而是风险等级概率,为了衡量卡机风险程度的大小,对实际工程施工有参考意义,本文将决策表中400组数据的条件属性(根节点的状态)作为证据,反推出贝叶斯模型卡机概率P0,并与决策属性(现场卡机情况)的卡机概率P1对比,进行数据分析,得出关系如表9所示.
3.4. 讨论分析
在无证据条件下,根据决策表中的数据,进行BN模型推理,TBM卡机概率为8%(极低风险),敏感性风险因素为岩石类型、大量的地下水、断裂破碎带,说明这3类因素是影响TBM施工的最不利因素.
表 8 TBM卡机风险因素统计表
Tab.8
研究区间 | 条件 | PJ/% | F | C ′ | F ′ | 现场是否卡机 |
原始数据 | 无证据 | 8 | A1、A2、A5 | A1→M6→M1→G、 A2→M6→M1→G、 A3→M7→M2→G、 M4→M2→G | A1、A2、A5 | |
21+004.542~21+543.213 | A1=3、A2=2、A3=1、A4=4、A5=4、 A6=2、A7=2、A8=3、B1=3、B2=2、 B3=4、C1=1、C2=4 | 0 | A5、A6 | A1→M6→M1→G、 A2→M6→M1→G、 A3→M7→M2→G、 M4→M2→G | A1、A2、A5 | 否 |
40+022.111~41+025.123 | A1=4、A2=2、A3=4、A4=2、A5=3、 A6=4、A7=2、A8=4、B1=3、B2=2、 B3=4、C1=3、C2=3 | 53 | A5、M4、M2 | A1→M6→M1→G、 A2→M6→M1→G、 A3→M7→M2→G、 M4→M2→G | A1、A2、A5 | 是 |
50+409.187~51+011.235 | A1=2、A2=1、A3=4、A4=3、A5=2、 A6=2、A7=2、A8=3、B1=3、B2=2、 B3=4、C1=1、C2=4 | 47 | M6、M1 | A1→M6→M1→G、 A2→M6→M1→G、 A3→M7→M2→G、 M4→M2→G | A1、A2、A5 | 是 |
表 9 TBM卡机的模型概率和现场概率
Tab.9
风险定义 | P0/% | P1/% |
极高风险 | | |
高风险 | | |
中等风险 | | |
低风险 | | |
极低风险 | | |
在有证据条件下,TBM1施工段(21+004.542~21+543.213),由该模型获取TBM卡机概率为0%(极低风险),敏感性风险因素为断裂破碎带、围岩等级,通过实地考察该区间大部分为凝灰质砂岩,整体稳定性较好,无较大断裂破碎带、涌水、软弱围岩等不良地质,施工环境较好. TBM1施工段(40+022.111~41+025.123),该模型计算出卡机概率为53%(极高风险),敏感性风险因素为断裂破碎带,敏感性风险事件为围岩坍塌、卡刀盘,通过实地考察该区间存在约50 m长的断裂破碎带,围岩稳定性和节理较差,当TBM施工至40+424.236~40+867.278处时,多次出现严重的塌方掉块现象,2次塌方致使刀盘楔嵌卡机. 塌方掉块现场照片如图11所示. 在TBM2施工段,经该模型推理计算,TBM卡机概率为47%(极高风险),敏感性风险因素为大量地下水,敏感性风险事件为突泥涌沙、卡刀盘,经实地调查,该区间存在富水地段,节理裂隙发育,为节理密集带,岩体破碎,呈碎石、块状结构;当TBM施工到50+900.456处时,刀盘内出现极大涌水,瞬时流量约400 m3/h,TBM停止掘进,停机堵水30天. 突涌水现场照片如图12所示. 经该模型推理分析,找出4条最容易致使TBM卡机的关键致因链:岩石类型→掌子面突泥涌沙→卡刀盘→卡机;大量的地下水→掌子面突泥涌沙→卡刀盘→卡机;高地应力→软岩大变形→卡护盾→卡机;围岩坍塌→卡护盾→卡机,决策者可以通过阻断关键路径,避免TBM卡机事件的发生. 通过对比分析发现,该模型的推理结果和现场施工情况基本一致,可为TBM卡机风险管理提供一定的理论依据.
图 11
图 12
4. 结 论
(1)从地质条件、设计因素和施工管理水平3个方面,筛选造成卡机故障的13个风险因素和7个风险事件,利用解释结构模型解决风险因素和风险事件的因果逻辑关系. 通过相关规范、研究成果和云模型区间划分法对各指标进行区间等级划分,以此建立BN的TBM卡机模型.
(2)通过粗糙集分类原理从实测数据中获取根节点的先验概率和中间节点的条件概率,经过推理计算,在无证据条件下TBM卡机风险等级概率为8%(极低风险),岩石类型、大量地下水和断裂破碎带为最关键风险因素.
(3)运用该模型对双三隧道3个施工区段进行TBM卡机风险预测,推理出风险等级概率,找出敏感性风险因素和风险事件,并和实际工程施工情况做对比,评价结果和实际情况基本吻合,验证了该评价方法的科学性.
(4)基于粗糙集−BN法的TBM卡机模型,通过大量的实测数据可以确定无证据条件下TBM施工过程中造成卡机的关键路径. 该模型可以运用于类似工程,只需掌握相应工程的节点证据,输入相应参数即可动态更新TBM卡机风险等级概率,获得风险等级. 该过程简单易行,操作方便,可作为TBM卡机风险管理的决策工具.
(5)所建模型没有考虑机械故障和人为原因所造成的停机情况;此外,由于对采集的数据均来自敞开式TBM施工项目,仅适应于敞开式TBM,其他类型的TBM施工项目使用该模型,须采集相应类型施工项目的施工数据,进行模型更新.
